Secondary Water System Phase III Project

About

Roosevelt City has been focused on providing a secondary water system to its residents since 2008. Existing infrastructure was installed during two previous projects/phases, along with minor expansions during road reconstruction projects. The secondary water system is a critical piece of infrastructure that reduces strain on the culinary water system and sources by providing a separate source of water to use for outdoor irrigation. In May of 2024, Roosevelt City was awarded a $2M grant from the Division of Water Resources to install additional piping and supply secondary water to areas without this service.

10/09/2024 Update – Roosevelt City Secondary Water Phase III Project

The Secondary Water Project is winding down for the winter, and will pick back up in the spring. This past week, the contractor has completed the work that is scheduled for this fall. During the next few days, they will be going around town and cleaning up areas they have been staged or completed construction.

Next spring, and when weather permits, the contractor will install secondary water line and services on 1875 South. This will be the last update until they remobilize in the spring. We appreciate everyone’s patience and understanding as this important project has been underway.

09/19/2024 Update – Roosevelt City Secondary Water Phase III Project

The Secondary Water Project is continuing throughout the city, and the project team wanted to get a mid-week update out to the community. The asphalt crew has prepped areas along Gates Drive and Nelson Avenue to begin the asphalt patching. Unfortunately, the contractor could not get asphalt this week due to asphalt plants being broken down. The plan is to have asphalt on Monday, 09/23/2024, to patch those areas. In the meantime, crews will fill in areas that need to be filled in for access to driveways, while placing cones/delineator posts to mark the areas that have been prepped for asphalt.

The project team appreciates your understanding and patience. We will send out our weekly update on Friday with the schedule for next week.

09/09/2024 Update – Roosevelt City Secondary Water Phase III Project

The Secondary Water Project continued throughout the city last week in multiple areas. The road repair crew finished patching up near 300 North and 750 West, as well as Gates Drive. The service crew finished installing services in the area of 1150 South, and the main line crew installed pipe on 1700 South and State Street down to 1800 South. This next week, the main line crew will install pipe on 1800 South between State Street and 500 East. The service line crew will install services on 1700 South, and the road repair crew will begin trench patching on 1080 South.

The project team asks that those traveling on these roadways remain vigilant, obeying the traffic control that is in place. Also, it is important that vehicles are not parked on the roadway between the hours of 7:30 A.M. and 5:30 P.M wherever crews are present. This is to provide sufficient room for the crew to work and to prevent any accidental damage to vehicles. Thank you for your understanding and patience as this project moves along.

08/23/2024 Update – Roosevelt City Secondary Water Phase III Project

The Secondary Water Project continued this past week in multiple areas throughout the city. There was a crew that installed main line on 1080 South and 50 East, and another crew installed services on Gates Drive. The plan for this next week is to continue installation of main line on 1150 South and 1700 South. The service crew will follow shortly behind, installing services on 1080 South, 50 East, and 1150 South. Additionally, there will be a crew patching the trenches where work is completed. These areas include 350 North, 750 West, 950 West, 300 North, Gates Drive, and Nelson Avenue.

With school starting this past week, the roadways are busier, and the project team asks that those traveling on these roadways remain vigilant, obeying the traffic control that is in place. Also, it is important that vehicles are not parked on the roadway between the hours of 7:30 A.M. and 5:30 P.M wherever crews are present. This is to provide sufficient room for the crew to work and to prevent any accidental damage to vehicles. Thank you for your understanding and patience as this project moves along.

08/16/2024 Update – Roosevelt City Secondary Water Phase III Project

The Secondary Water Project continued this past week in the area of Nelson Avenue and Gates Drive, completing main line in this area. In order to prepare for excavation on other streets, the crew also milled the asphalt on 100 South, 1080 South, and 1700 South. The plan for the next week is to have a crew saw cutting asphalt in areas where the main line is already installed in preparation for asphalt patching. Another crew will be installing main line on 1080 South, with an additional crew installing services.

It is important to note that 1080 South will be closed between State Street and 320 East on August 19 until August 22. There will be no access for thru traffic, so access to Centennial Elementary will need to be from 500 East. Additionally, we ask that foot traffic through this area be minimized. If children will be walking this route, we ask that they remain vigilant, staying on sidewalks and away from the construction equipment and construction sites.

Additionally, the project team asks that no vehicles or trailers are parked on the roadway between the hours of 7:30 A.M. and 5:30 P.M wherever crews are present. Thank you for your understanding as the project team completes this project.

08/13/2024 Update– Roosevelt City Secondary Water Phase III Project

The Secondary Water Project with Roosevelt City continued this week along Gates Drive. Main line was installed, and a service crew installed services as well. The work for this week ended around Gates Drive and Nelson Avenue, so next week the contractor will work their way down Nelson Avenue and then from Nelson Avenue down Gates Drive to 200 North. Once that is completed, crews will move down to 1080 South between State Street and 320 East.

When construction crews are on 1080 South, the road will be closed to local traffic only until main line is installed. With school starting soon, it will be important to plan routes to school avoiding 1080 South until the road is reopened. Additionally, the project team asks that no vehicles or trailers are parked on the roadway between the hours of 7:30 A.M. and 5:30 P.M.

As always, safety is a number one priority, so to protect the public, and especially children, the project team asks that children are kept away from the construction equipment, so accidents do not occur. The city and the construction team are excited to get this project completed to conserve water, and we want to do it without any accidents or injuries as well. We thank the public for the cooperation as the project continues.

08/02/2024 Update – Roosevelt City Secondary Water Phase III Project

The Secondary Water project continued this week in the area of 300 North between 750 West and 950 West, with service installation, drain installation, and air release station installation. Crews then moved to Gates Drive, installing main line from 750 West heading toward the west end of the road. This next week, it is planned that main line installation will continue on Gates Drive. As the project continues, crews will drop off project notifications and stakes for the marking of service locations to homeowners on the affected roads.

During construction, it has been noticed that there are unsupervised children from the neighborhood very near to the project location and the construction equipment. To protect the public, and especially the children, the project team asks that children are kept away from the construction equipment, so accidents do not occur. The city and the construction team are excited to get this project completed to conserve water, and we want to do it without any accidents or injuries as well. We thank the public for the cooperation as the project continues.

07/26/2024 Update – Roosevelt City Secondary Water Phase III Project

Johansen Construction continued on the secondary project, installing mainline on 350 North between 750 West and 1000 West, as well as on 300 North and 750 West. It is planned to complete the main line on 300 North and 950 West within the next couple of working days, and then crews will focus on installing services on those roadways as well. Thank you for the coordination that has occurred so far regarding meter placement, and we ask that those that have not placed the stakes for their meter location do so prior to crews arriving at your property. A reminder to move vehicles and trailers parked on the roadways between 7:00 A.M. and 5:30 P.M. in order to avoid interruptions to the project. Thank you for your cooperation and continued patience as the project continues.

07/19/2024 Update – Roosevelt City Secondary Water Phase III Project

Johansen Construction continued on the secondary project, installing mainline on 350 North between 750 West and 1000 West. Services were installed to multiple homes on that road this past week as well. It is anticipated that mainline installation will continue in the area, focusing on 950 West, 300 North, and 750 West followed by the installation of service lines and meters. Asphalt repair is included as part of the project; however, it will be completed at a later date. As construction continues, we ask that vehicles and trailers not be parked on the roadways between 7:00 A.M. and 5:30 P.M. in order to avoid interruptions to the project. Thank you for your cooperation and continued patience as the project continues.

07/12/2024 Update – Roosevelt City Secondary Water Phase III Project

Johansen Construction began the project on July 1, 2024, at 200 North and 1000 West. The main line has been installed on 1000 West as well as Bonnie Drive. Services, including service lines and meters, are being installed along that same stretch. The services should be completed soon and clean up and pressure testing are scheduled for the early part of the week of July 15. It is important to note that the trenches on 1000 West and Bonnie Drive will be backfilled with millings instead of repaired with asphalt. This is due to a road repair project that is scheduled for early 2025 to reconstruct both Bonnie Drive and 1000 West. Upon completion of the pressure testing, the crews will move to 350 North between 1000 West and 750 West where they will begin installing the main line. Thank you for your patience and understanding as the project continues.

Installation Areas

Secondary water lines and meters will be installed in three areas in Roosevelt City. Installation will begin on July 1, 2024, in the Bonnie Drive / Nelson Avenue / Gates Drive neighborhood area shown on the map below labeled "C-100A". It is anticipated that installation will take approximately one month for each area. Scheduling for the remaining areas is to be determined, and this page will be updated as more information is available.

Secondary Phase III, Street Reconstruction, & Transite Replacement

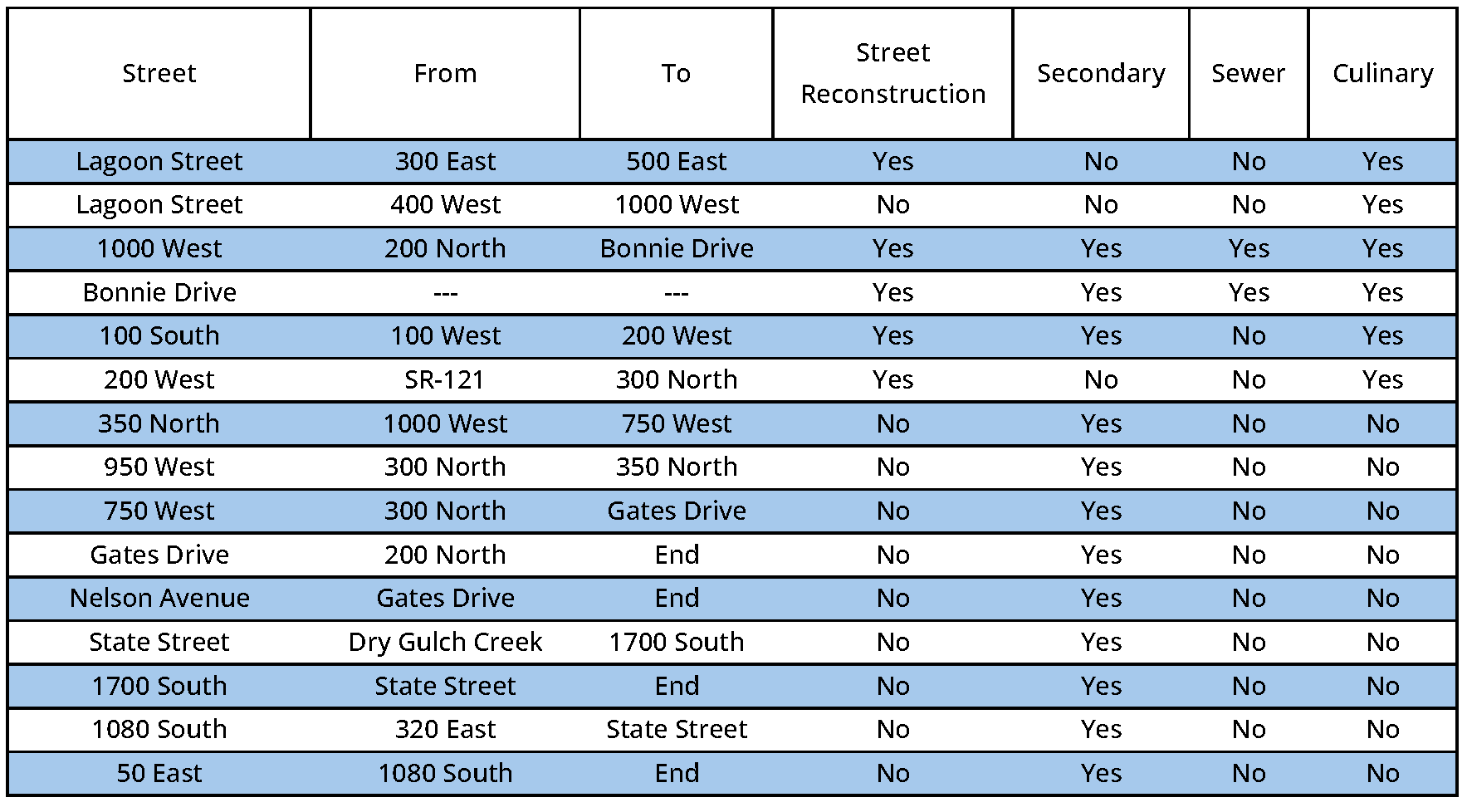

Phase III Table

C-100A Secondary Water Service Installation Area- Starting July 1, 2024

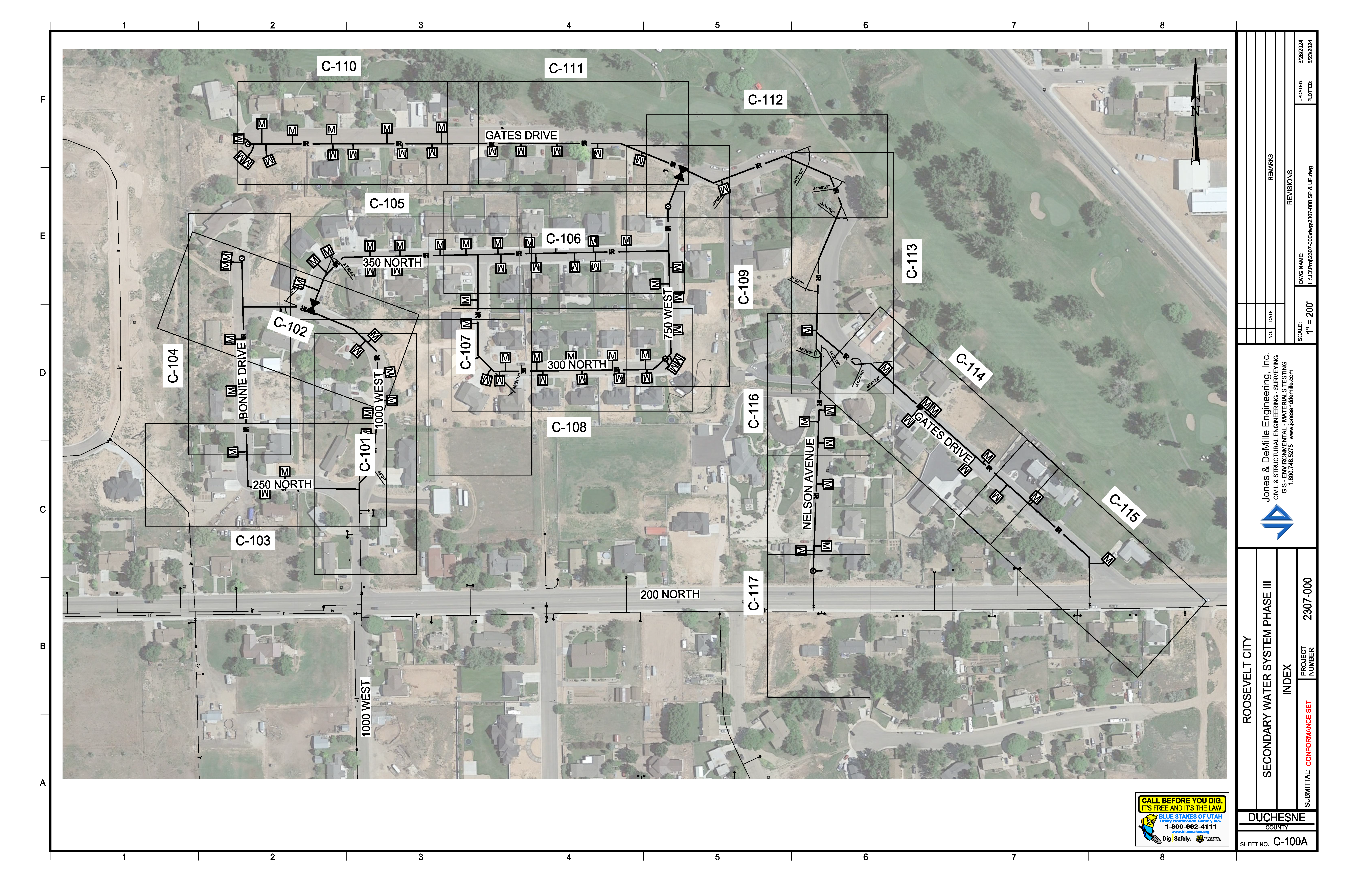

Map showing secondary waterline installation area "C-100A"

C-100B Secondary Water Service Installation Area- Start Date TBD

Map showing secondary waterline installation area "C-100B"

C-100C Secondary Water Service Installation Area- Start Date TBD

Map showing secondary waterline installation area "C-100C"

Roosevelt City Secondary Water Service Requirements

Roosevelt City requires residents to connect to secondary water service, where available. Residents are also required to pay for the cost of the connection as set by the Consolidated Fee Schedule Resolution. The current cost of a secondary water connection is $500.00 per residence, and the cost may be paid with your utility bill over a period of 12 months.

In addition to the connection fee, all residents with a secondary connection are required to pay a $6.00/ month (year-round) base rate plus the cost of their actual usage according to this Secondary Water Rate Table. Residents over the age of 65 are eligible for free secondary water usage up to 6,000 gallons a month, after which they will be required to pay for their usage.  Residents over 65 are still required to pay the monthly base rate. To receive this discount, please come and speak with our customer service representative. Links to Municipal Code citations for our secondary water service requirements can be found below.

R13.04.450 Required Connection

R13.04.460 Culinary System Must Be Completely Separate from the Secondary System

R13.04.470 Sprinkling Required

R13.04.480 Connection Fees and Monthly Service Fees
